Documented case · Turbine-generator train

Generator replacement in a gas turbine train in the State of Mexico

Removing the generator from its enclosure and installing a replacement with different supports defined the mechanical challenge. TEMISA carried out generator removal and mechanical installation of an IDEAL ELECTRIC replacement in a Solar Turbines gas turbine train in the State of Mexico.

TEMISA Power Gen · Published

Generator on an auxiliary steel frame with handling equipment around it.

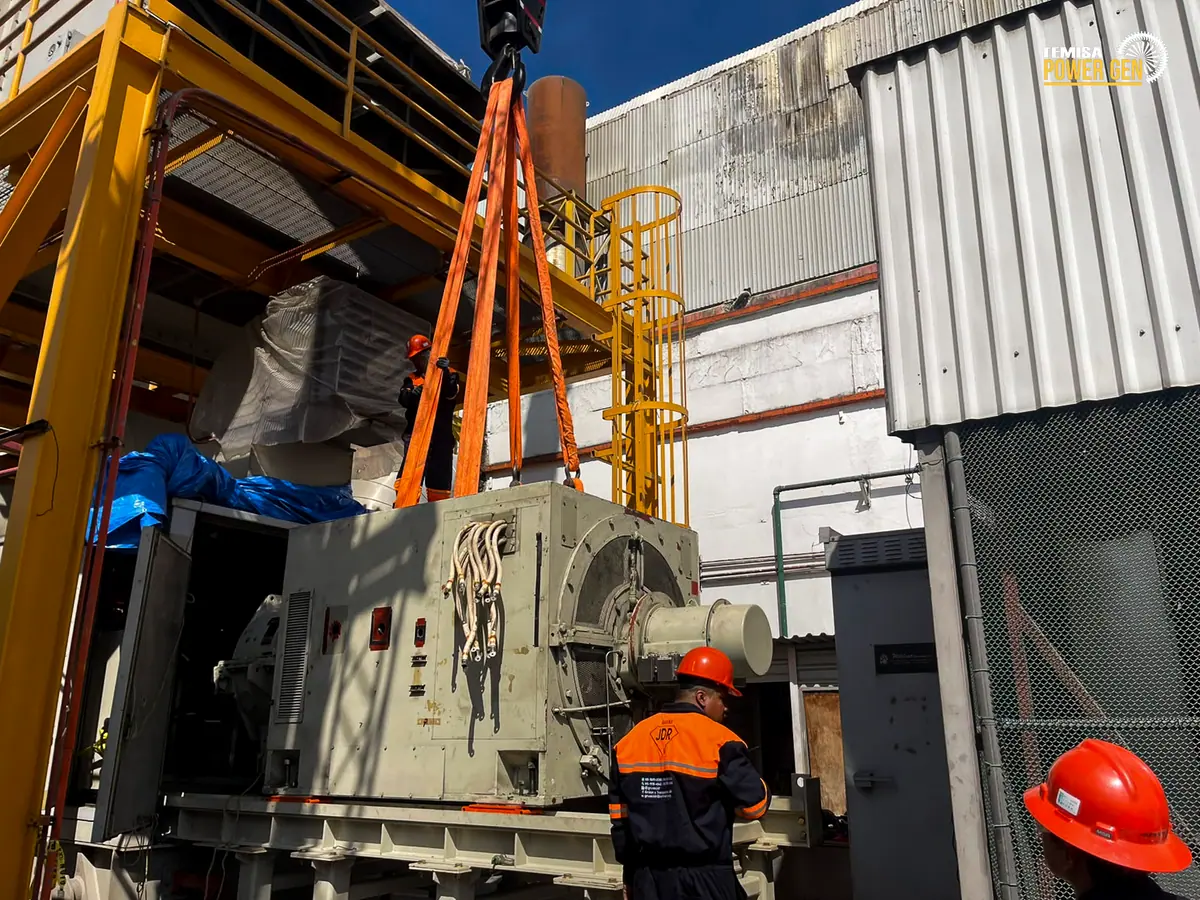

IDEAL ELECTRIC generator on the auxiliary frame during replacement in a train driven by a Solar Turbines gas turbine.
Project data
ItemRecord
Removed generatorIDEAL ELECTRIC · 6.6 kV · 1,800 rpm
Replacement generatorIDEAL ELECTRIC · 6.6 kV · 1,800 rpm
Common electrical data60 Hz · 0.80 power factor · class F insulation
Train configurationSolar Turbines gas turbine → gearbox → generator
Project locationState of Mexico, Mexico
Field interventionSeptember 17–28, 2026 · 12 calendar days
TEMISA scopePreparation, disconnection, removal, logistics, insertion, anchoring, pre-alignment and system reinstatement
Plant-supplied resource100 t crane for removal and insertion; this rating is the crane capacity

The challenge: enclosure access and different support geometry

Enclosure access and obstructions constrained removal. Differences in support geometry required positioning and pre-alignment adjustments for the replacement generator.

Dismantling: disconnecting and retaining references

Work began with access arrangements, permits and lockout/tagout (LOTO). Alignment references were recorded, and power, communications, instrumentation and space-heater connections were disconnected. Lubrication lines, guards and enclosure components were removed to open the extraction route and protect parts that would later be reinstated.

Technicians working beside the generator inside the enclosure.

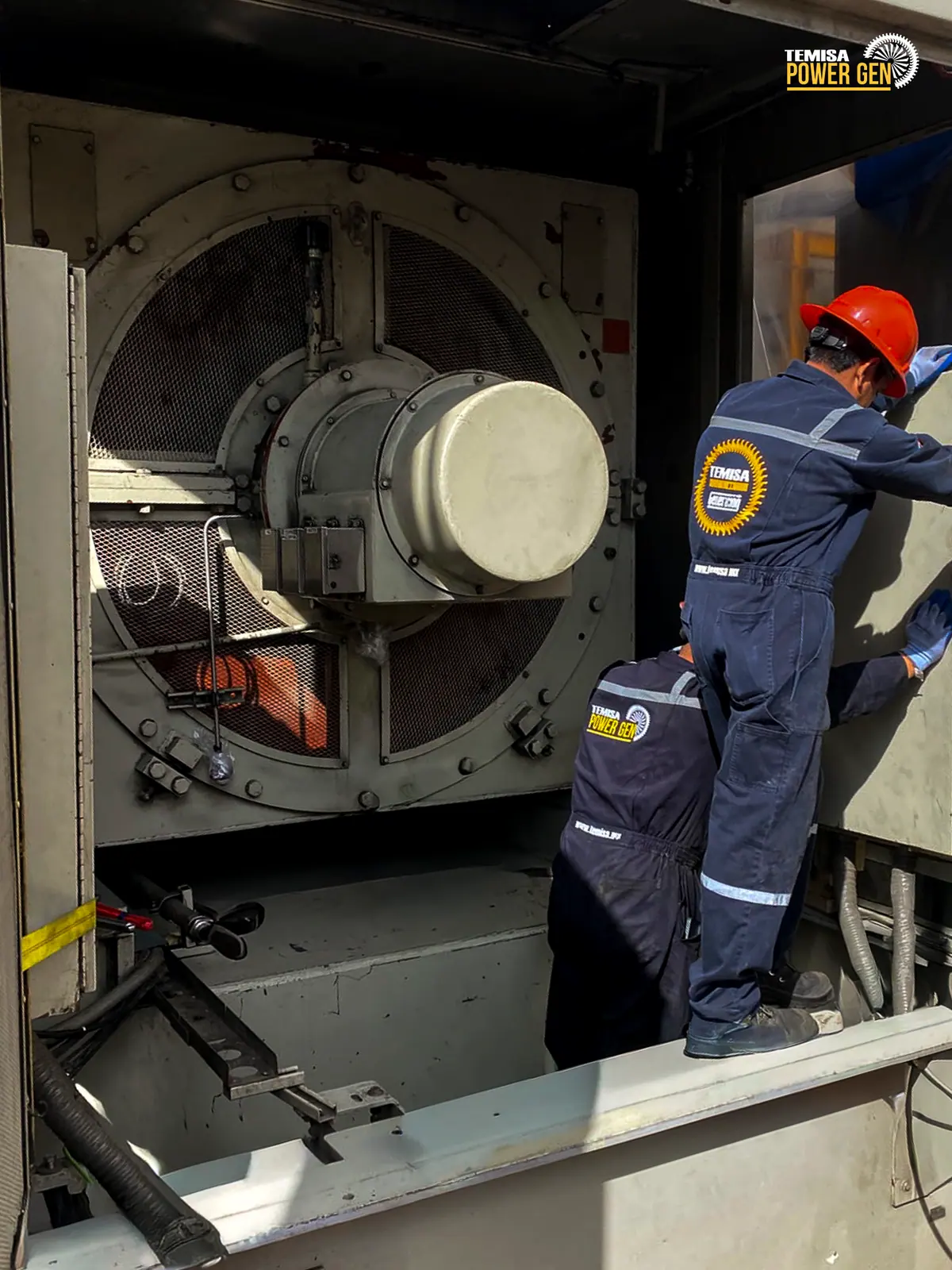

Enclosure preparation and disconnection of the IDEAL ELECTRIC generator.

Generator removal through lifting and controlled movement

The crew installed and levelled an extraction frame. Hydraulic jacks, temporary supports, machinery skates and chain hoists were used to lift and progressively move the generator to the enclosure exit. The plant supplied a 100 t crane for removal and insertion of the replacement. The crane rating does not represent generator mass.

Technicians operating handling equipment beside the generator on its support frame.

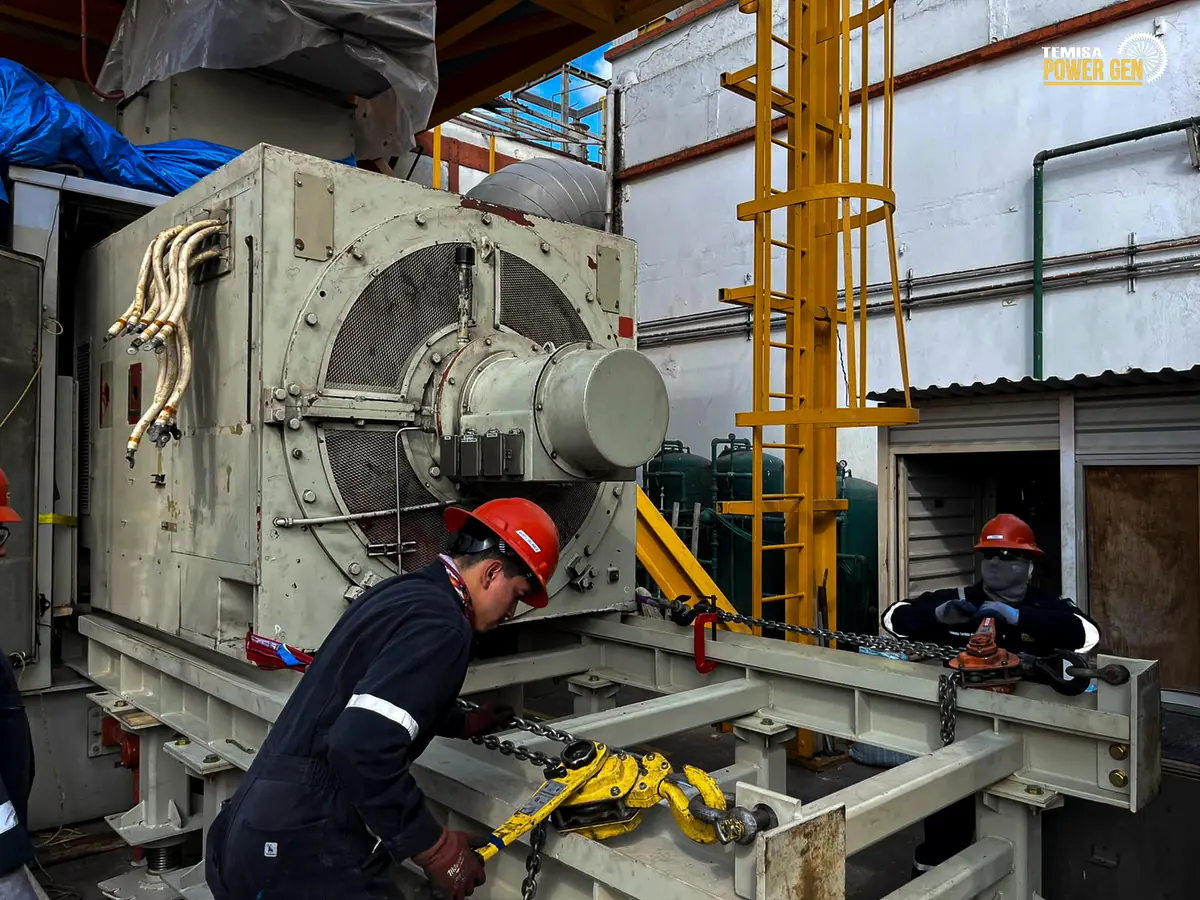

Moving the generator using supports and chain hoists.

Lowboy transport from the Tlajomulco workshop

The replacement generator was prepared at the TEMISA workshop in Tlajomulco de Zúñiga, Jalisco. The logistics scope covered lowboy transport to the State of Mexico and return of the removed generator to the workshop. Extraction, lifting, loading, transport and receipt are separate activities with defined resources and responsibilities.

Generator loaded on a transport platform with a crane in the background.

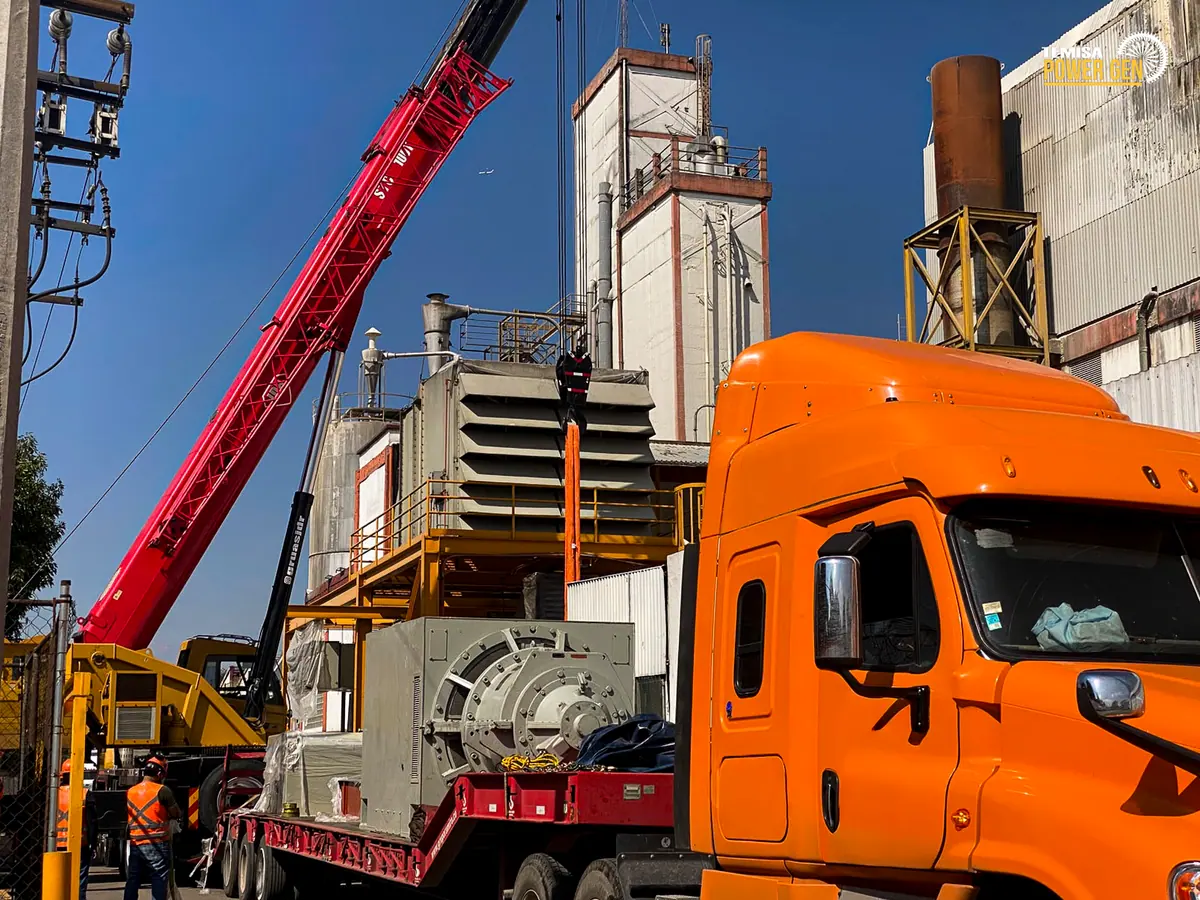

Generator loaded on a lowboy as part of the logistics between the Tlajomulco workshop and the State of Mexico.

Mechanical installation and pre-alignment

After insertion, the crew installed anchors and adjusted pre-alignment references to address the different base geometry. Lubrication, power, excitation, instrumentation, panels and guards were reinstated. The record includes tightening, terminal-box sealing and RTD/PT-100 signal checks.

Two technicians beside the generator and auxiliary frame in front of the enclosure.

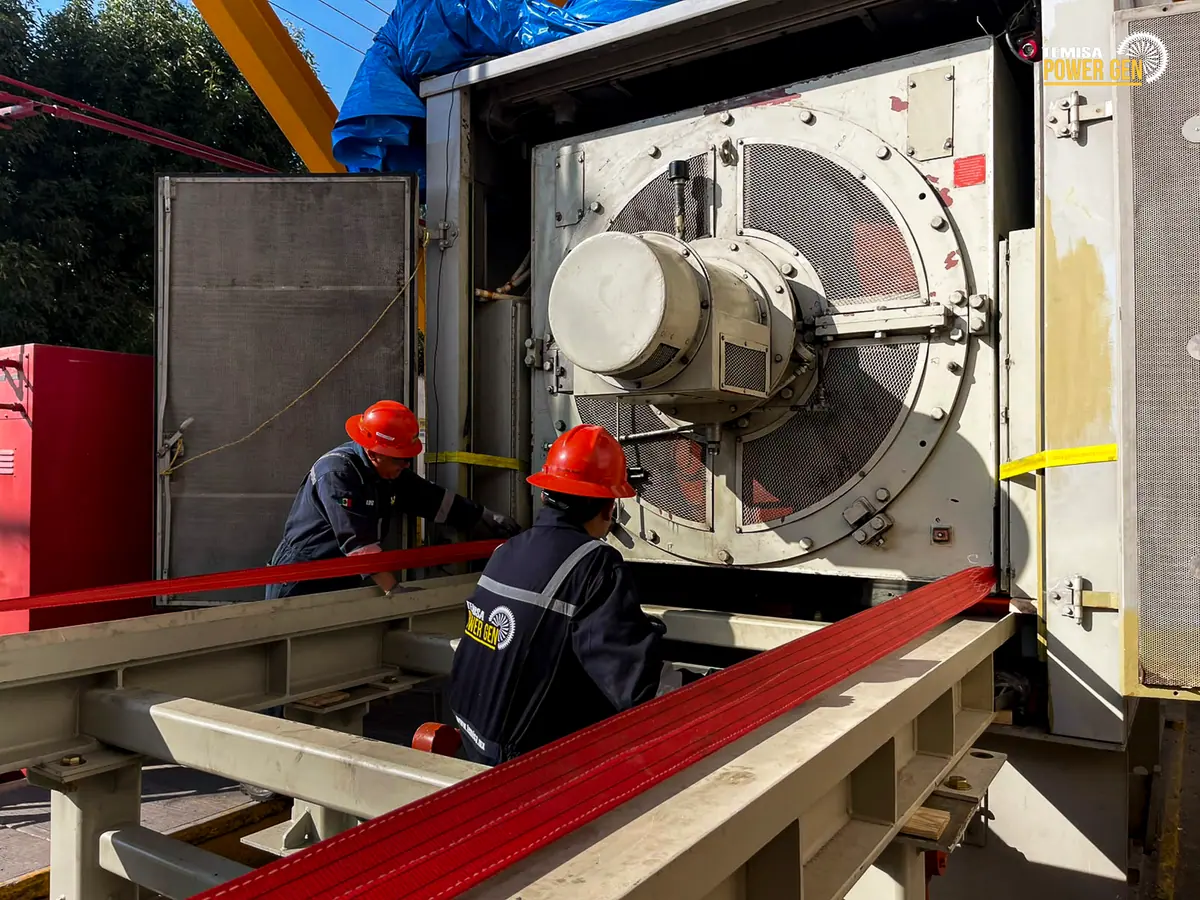

TEMISA personnel during generator replacement and mechanical installation.

TEMISA is an independent workshop. Solar Turbines and IDEAL ELECTRIC are trademarks of their respective owners and are cited solely to identify the equipment.

FAQ

Frequently asked questions

Questions we often receive. Can't find yours? Email us at ventas@temisapowergen.mx.

What information is needed to quote a generator replacement?

Nameplates for both generators, photographs of the enclosure and access route, verified dimensions and mass, location and planned intervention window. The proposal must also identify who supplies the crane, transport platform, disconnections and receiving resources.

Can removal, transport and installation be included?

Yes. The scope can combine those stages. The proposal should separately define preparation, removal, lifting, loading, transport, unloading, positioning and system reinstatement, including resources and responsibilities.

Can a replacement have a higher nameplate rating?

A change in rating requires electrical, mechanical and complete-train review. Matching brand, speed or voltage alone does not demonstrate interchangeability.

Does TEMISA or the plant supply the crane?

This is agreed for each project based on access, mass and the handling plan. The plant supplied a 100 t crane for this case; that resource is not a universal requirement for other generators.

How is a generator replacement schedule defined?

The schedule depends on access, dimensions, scope, logistics and resource availability. The dates in this case record describe this intervention and are not a standard lead time.

Plan the intervention

From your equipment to a defined scope

Share the information you have. We will review conditions to define resources, responsibilities and project stages.

  • Nameplates for the existing generator, replacement and prime mover.
  • Photographs of equipment, connections, base, enclosure and access.
  • Verified dimensions and mass, plus support and handling documentation.
  • Extraction and receiving routes; transport origin and destination.
  • Project location, entry restrictions and planned intervention window.
  • Required stages and resources supplied by each party.

You can submit your request even if some equipment details are still unknown. We will request the nameplate, access photographs and dimensional and mass records during follow-up.

Talk to TEMISA

Request a quote by email
